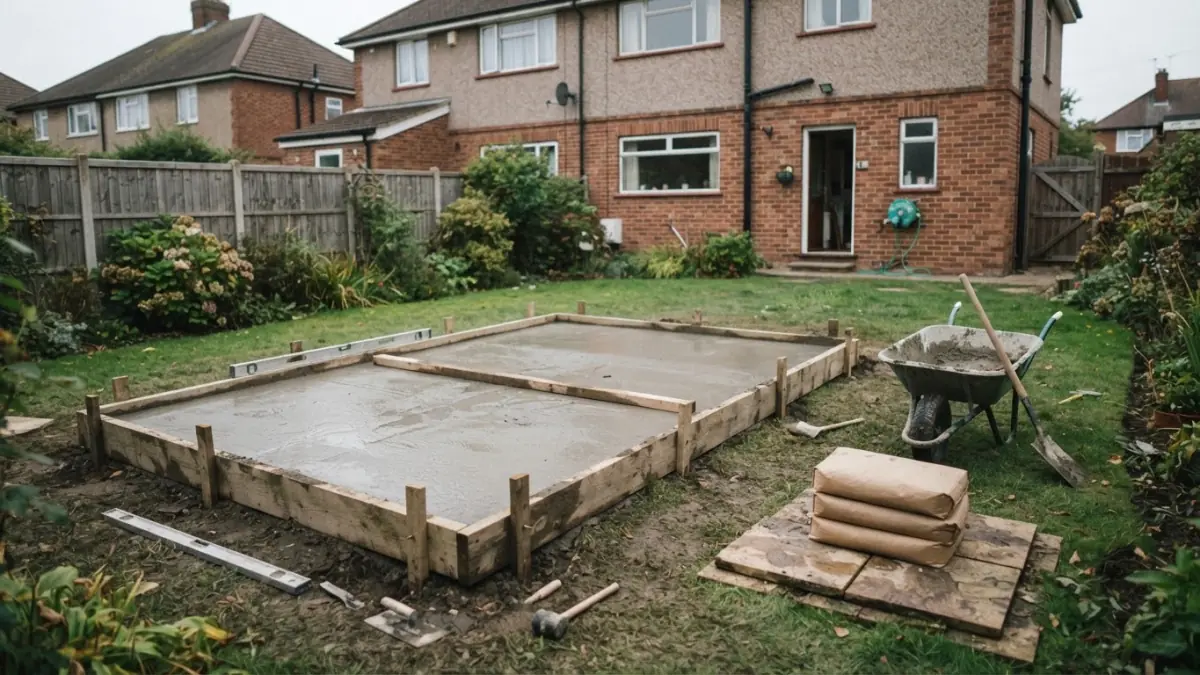

How much concrete do I need for a slab or shed base?
Multiply the area by the thickness and add an allowance for an uneven base and spillage. A 2.4 m × 1.8 m shed base 100 mm thick is about 0.43 m³, and about 0.48 m³ with 10% extra (each rounded from the exact sum below); the 100 mm and the 10% are examples, not advice; the thickness is yours. Then buy it one of three ways:
- In bags of dry mix: 48 bags that each make 0.01 m³, one maker’s figure for a 20 kg bag (read yours); 960 kg to carry and mix.
- Mixed yourself on site: 7 bags of cement and a bulk bag of all-in ballast, at the quantities Tarmac publishes and a typical bulk bag’s size.
- Ordered ready-mixed: about 0.48 m³, ordered in your supplier’s steps (0.5 m³ where it sells in 0.25 m³ steps) and no less than its smallest load.
Read here; this page sends and keeps nothing.
Work out the concrete for this slab, then change it to yours

The four figures
- The area. Length times width for a rectangle, in metres, measured inside the formwork. A base that is not a rectangle can be drawn in the calculator, or split into rectangles.
- The thickness, in millimetres. It depends on what the slab is for, the load and the ground, and it comes from the product’s instructions, a designer or building control. The example uses 100 mm because it is a round figure for the sum.
- The allowance. A base is never perfectly level, and some mix is lost in the barrow and the formwork. BuildBatch adds 10%, a labelled example.
- What one bag makes, in cubic metres, as printed on the bag, and the bag’s weight. Or, for ready-mixed concrete, the step your supplier sells in.
Mixing it yourself from cement, sand and aggregate
Bagged dry mix is the simplest for a small base. For a bigger one it is usual to buy cement, sharp sand and coarse aggregate, or cement and all-in ballast (sand and stone together), and mix them on site. How much of each makes a cubic metre is a maker’s figure, not BuildBatch’s: the calculator counts a general purpose mix with all-in ballast at the quantities Tarmac publishes for 2.5 m³, read on 9 October 2026, and labels every such line a typical figure. Tarmac’s figures for all three of its mixes are below.
| Mix, for 2.5 m³ | Cement (25 kg bags) | Damp sand | Coarse aggregate | Or all-in ballast |
|---|---|---|---|---|
| General purpose | 35 | 1.25 m³ | 1.8 m³ | 2.5 m³ |
| Paving | 40 | 1.0 m³ | 1.75 m³ | 2.5 m³ |
| Foundation | 30 | 1.25 m³ | 2.0 m³ | 2.5 m³ |
The maker says these quantities include no allowance for wastage, and advises rounding the aggregates up to the nearest half or full cubic metre and buying an extra 10% of cement. The calculator applies the slab’s own allowance to the volume first, counts the cement in whole bags, and counts each aggregate in bulk bags of about 0.5 m³, a typical figure from a merchant’s own pages, named on its line, or in 25 kg bags where 20 or fewer cover it (a rule of BuildBatch’s own, not a maker’s). For the shed base above (0.4752 m³ with its 10%), a general purpose mix is 0.4752 ÷ 2.5 = 0.19 of the maker’s quantities: 35 × 0.19 = 6.65, so 7 bags of cement, and 0.4752 m³ of ballast, so 1 bulk bag. Sand and ballast are also sold loose by the tonne and in 25 kg bags: what your merchant’s bag fills is the figure to buy by.
Which mix a slab needs, and how much water, are for the cement’s instructions, a designer or building control. BuildBatch does not design the mix.
The sum
Area × thickness ÷ 1,000 = the volume in cubic metres (the thickness is in millimetres). Add the allowance once. For bags, divide by the yield printed on the bag and round up to a whole number; for ready-mixed, round up to the supplier’s step.
Which way the calculator starts on
Until you choose, the calculator goes by the volume with its extra:
- up to 0.25 m³: bags of dry mix. A 20 kg bag makes about a hundredth of a cubic metre, so 0.25 m³ is 25 bags and half a tonne;
- up to 1 m³: cement and ballast, mixed on site;
- above 1 m³: ready-mixed concrete, delivered. The smallest loads the suppliers read deliver start at half a cubic metre or one.
The two thresholds are BuildBatch’s own. No maker or supplier publishes such a rule, and the list says so and shows what the other two ways take. The shed base below, 0.4752 m³, is counted mixed on site: 48 bags of dry mix would be 960 kg to carry and mix.
Worked example
A shed base 2.4 m × 1.8 m is 4.32 m². At 100 mm that is 0.432 m³, and with 10% extra, 0.4752 m³. At 0.01 m³ a bag, 0.4752 ÷ 0.01 = 47.52, so 48 bags; at 20 kg each, 960 kg to carry and mix. Ready-mixed, from a supplier who sells in 0.25 m³ steps, the same base is 0.5 m³.
These are example figures. Use the thickness decided for your job, and check the yield and the weight against the figures on your bag.
What the sum leaves out
What goes under the slab, and how deep, is not decided by it: concrete is laid on a prepared, compacted sub-base, never on soil or turf. The calculator counts a sub-base of Type 1 (MOT) at a typical 100 mm, said to be typical and not a design, until you enter the depth decided for the job. It is laid 75 mm wider than the slab all round, for the formwork, as one maker’s guide to laying concrete says; that area times the depth is the compacted volume, and 10% is added for spreading and an uneven dig. Under the shed base that is 4.97 m² × 100 mm = 0.497 m³, and 0.547 m³ with the 10%: 2 bulk bags, or 46 bags of 25 kg. A bulk bag is taken at about 0.38 m³ once compacted: an 800 kg bag at about 2.1 tonnes a cubic metre, the middle of the figures suppliers and quarries give for compacted Type 1, read on 12 October 2026. As the figure is for the material compacted in place, nothing is added for settlement. It is a typical figure, named on the line; no maker’s data sheet read gives one (Holcim’s and Heidelberg Materials’ Type 1 sheets give the grading only). Whether the slab needs a damp-proof membrane or reinforcement depends on what it is for: the list asks, and counts a membrane as one 50 m² roll. Formwork boards run round the edge, pegged firmly on the outside, and the new concrete is protected from drying out, rain and frost while it hardens: the bag’s instructions give the temperature limits, the working time and the protection period. Mixing your own from cement, sand and aggregate is counted at the maker’s published quantities, as the section above says.
Wet cement is alkaline and burns skin: wear waterproof gloves, eye protection and boots, and wash any splash off at once.
Do it with BuildBatch
Open the concrete calculator, type the slab’s length and width or its area, and the thickness you have decided on under “Thickness”. It shows the three ways to buy the concrete, with what each takes and the one usual for that volume marked: press the one you want. The shopping list has the sub-base in bags, at a typical 100 mm until you type the depth decided for the job under “Sub-base depth” in “Change the figures”, the formwork, and the membrane and the reinforcement as lines to decide, each with its question. Paving slabs on a mortar bed are counted differently, in sand, cement and slabs: see how much sand and cement for a patio. For a shed base, a table by shed size gives the bags for ten sizes from 6 × 4 ft to 16 × 10 ft.
Having it laid instead: the cost to lay a concrete base gives what UK cost guides publish, each with the day read, and the sum for a 4 × 3 m base.
Sources
- Tarmac: “What mix ratios of cement do you recommend for general purpose concrete?”, for a paving mix and for foundation concrete (each last updated 24 November 2020, read in full on 9 October 2026): the bags of cement (nominal 25 kg), damp sand, coarse aggregate or all-in ballast for 2.5 m³ of each mix; that the quantities include no wastage; the advice to round aggregates up to the nearest half or full cubic metre and add 10% of cement.
- Tarmac: Blue Circle Multi-Purpose Concrete, product data sheet (December 2023): the yield of a 20 kg bag, the water, the working temperatures, the working time and the protection period, read in full on 5 October 2026.
Questions
How many bags of concrete for a 2.4 m by 1.8 m shed base?
At 100 mm thick the base is 4.32 m² and 0.432 m³. With 10% extra that is 0.4752 m³; at 0.01 m³ a bag it is 47.52 bags, so 48 bags of 20 kg, which is 960 kg to carry and mix. For that much concrete BuildBatch counts the mix on site unless you choose bags: 7 bags of cement and a bulk bag of ballast. The thickness, the 10% and the yield are examples: use the thickness decided for your job and the yield printed on your bag.
How thick should a concrete slab be?
BuildBatch does not say. The thickness depends on what the slab is for, the load and the ground, and it is decided by the product's instructions, a designer or building control. The calculator's 100 mm is a figure for the worked example, not advice.
How much does one bag of concrete make?
It is printed on the bag, and it differs between products and bag sizes. One maker prints about 0.01 m³ for a 20 kg bag of multi-purpose mix. Read your own bag: the yield and the water it needs are the two figures the sum depends on.
How much cement and ballast do I need for a shed base?
At the quantities Tarmac publishes for 2.5 m³ of general purpose concrete (35 bags of 25 kg cement with 2.5 m³ of all-in ballast, or 1.25 m³ of damp sand and 1.8 m³ of coarse aggregate), a 2.4 m × 1.8 m base 100 mm thick with 10% extra (0.4752 m³) takes 6.65 bags of cement, so 7 bags, and 0.4752 m³ of ballast, which is 1 bulk bag of about 0.5 m³, a merchant's own figure for its bulk bag. The calculator counts the general purpose mix with all-in ballast. Which mix a slab needs is not BuildBatch's to say.
How many bags of sub-base under a slab?
BuildBatch counts bags, not tonnes, at a typical 100 mm until you give the depth decided for the job. The sub-base is laid 75 mm wider than the slab all round, for the formwork: under a 4.32 m² base that is 4.97 m², 0.497 m³ compacted, and 0.547 m³ with 10% for spreading and an uneven dig, which is 2 bulk bags at about 0.38 m³ once compacted, or 46 bags of 25 kg. The bag's figure is for the material compacted in place, so nothing is added for settlement; it is a typical figure, named on the line with where it was read.
Should I buy bags or order ready-mixed concrete?
Bags suit a small base you can mix by hand or in a mixer. For a larger slab the weight adds up fast: 48 bags is nearly a tonne. With no way chosen, BuildBatch counts bags of dry mix up to 0.25 m³, cement and ballast mixed on site up to 1 m³ and ready-mixed above: a rule of its own, not a maker's, and it shows what each way takes. Ready-mixed concrete is ordered by the cubic metre, and suppliers have a minimum load, half a cubic metre or one on the pages read, so ask.
